Toronto, March 16, 2021 – Adventus Mining Corporation (“Adventus”) (TSX-V: ADZN, OTCQX: ADVZF) and Salazar Resources Limited (“Salazar”) (TSX-V: SRL, OTCQB: SRLZF) (collectively the “Partners”) are pleased to announce continued infill drilling results from the El Domo volcanogenic massive sulphide deposit located within the 21,537-hectare Curipamba project in central Ecuador. Infill drilling for the ongoing feasibility study continues at El Domo with two diamond drill rigs having completed 42 infill definition drill holes totaling 4,725 metres from the planned 4,960 metres, and two drill holes in progress totaling a further 77 metres completed. The Partners anticipate that all infill, geomechanical, geotechnical, and hydrogeological drilling required to support the completion of the El Domo feasibility study and submittal of the environmental and social impact assessment will be completed by the end of March 2021.
Highlights – Drill Results from the El Domo Deposit at Curipamba:
- CURI-357 intersected 44.19 metres of 3.39% copper, 2.30 g/t gold, 0.42% zinc, 13.4 g/t silver, and 0.03% lead for 5.06% copper equivalent (“CuEq”) – including 23.83 metres of 5.96% copper, 2.79 g/t gold, 0.42% zinc, 19.6 g/t silver, and 0.04% lead for 7.99% CuEq
- CURI-356 intersected 10.92 metres of 5.81% copper, 1.58 g/t gold, 3.16% zinc, 34.3 g/t silver and 0.04% lead for 8.09% CuEq – including 3.79 metres of 12.05% copper, 3.67 g/t gold, 8.90% zinc, 67.9 g/t silver, and 0.09% lead for 17.73% CuEq
Drill hole CURI-356 intersected mineralized fine-grained sediments in the immediate hanging wall of the massive sulphide from 65.10 to 69.12 metres, grading 0.37% copper, 0.85 g/t gold, 2.87% zinc, 15.9 g/t silver, and 0.06% lead (1.94% CuEq). Massive sulphide mineralization was intersected from 69.12 to 80.04 metres, grading 5.81% copper, 1.58 g/t gold, 3.16% zinc, 34.3 g/t silver and 0.04% lead (8.09% CuEq). A higher-grade subset occurs from 69.12 to 72.91 metres, grading 12.05% copper, 3.67 g/t gold, 8.90% zinc, 67.9 g/t silver, and 0.09% lead (17.73% CuEq). In the footwall, a section of mineralized dacite autobreccia was intersected from 80.04 to 89.26 metres, grading 0.84% copper, 0.12 g/t gold, 0.16% zinc, 3.4 g/t silver and 0.02% lead (1.00% CuEq). A higher-grade subset was from 85.30 to 89.26 metres, grading 1.81% copper, 0.07 g/t gold, 0.03% zinc, 3.4 g/t silver and 0.01% lead (1.89% CuEq).
Drill Hole | From | To | Thickness | Cu (%) | Au (g/t) | Zn (%) | Ag (g/t) | Pb (%) | CuEq (1) | Approx. True Thickness (m) |
---|---|---|---|---|---|---|---|---|---|---|
CURI-356 | 65.10 | 69.12 | 4.02 | 0.37 | 0.85 | 2.87 | 15.9 | 0.06 | 1.94 | 3.02 |
| 69.12 | 80.04 | 10.92 | 5.81 | 1.58 | 3.16 | 34.3 | 0.04 | 8.09 | 8.19 |
Including | 69.12 | 72.91 | 3.79 | 12.05 | 3.67 | 8.90 | 67.9 | 0.09 | 17.73 | 2.84 |
| 80.04 | 89.26 | 9.22 | 0.84 | 0.12 | 0.16 | 3.4 | 0.02 | 1.00 | 6.92 |
Including | 85.30 | 89.26 | 3.96 | 1.81 | 0.07 | 0.03 | 3.4 | 0.01 | 1.89 | 2.97 |
- Metal equivalency based on US$4.10/lb Cu, US$1,723.50/oz Au, US$1.28/lb Zn, US$25.88/oz Ag and US$0.89/lb Pb; noting that no adjustments were made in the metal equivalency calculation for metal recovery. Prices taken from 6-month contracts for precious metals and 3-month contracts for base metals from the London Metal Exchange, dated March 12, 2021.
CURI-357 intersected a narrow section of well-mineralized grainstone with massive sulphide clasts in the immediate hanging wall of the massive sulphide from 51.26 to 52.34 metres, grading 0.50% copper, 1.74 g/t gold, 2.51% zinc, 71.1 g/t silver, and 0.72% lead (3.16% CuEq). The thick section of massive sulphide mineralization was from 52.34 to 96.53 metres, grading 3.39% copper, 2.30 g/t gold, 0.42% zinc, 13.4 g/t silver, and 0.03% lead (5.06% CuEq). A higher-grade subset of the massive sulphide mineralization was from 69.09 to 92.92 metres, grading 5.96% copper, 2.79 g/t gold, 0.42% zinc, 19.6 g/t silver, and 0.04% lead (7.99% CuEq).
Drill Hole | From | To | Thickness | Cu (%) | Au (g/t) | Zn (%) | Ag (g/t) | Pb (%) | CuEq (1) | Approx. True Thickness (m) |
---|---|---|---|---|---|---|---|---|---|---|
CURI-357 | 51.26 | 52.34 | 1.08 | 0.50 | 1.74 | 2.51 | 71.1 | 0.72 | 3.16 | 0.76 |
| 52.34 | 96.53 | 44.19 | 3.39 | 2.30 | 0.42 | 13.4 | 0.03 | 5.06 | 30.93 |
Including | 69.09 | 92.92 | 23.83 | 5.96 | 2.79 | 0.42 | 19.6 | 0.04 | 7.99 | 16.10 |
- Metal equivalency based on US$4.10/lb Cu, US$1,723.50/oz Au, US$1.28/lb Zn, US$25.88/oz Ag and US$0.89/lb Pb; noting that no adjustments were made in the metal equivalency calculation for metal recovery. Prices taken from 6-month contracts for precious metals and 3-month contracts for base metals from the London Metal Exchange, dated March 12, 2021.
CURI-359 intersected massive sulphide mineralization from 61.70 to 75.60 metres, grading 1.13% copper, 1.50 g/t gold, 2.75% zinc, 43.1 g/t silver, and 0.20% lead (3.35% CuEq). Three narrower subsets of higher-grade massive sulphide mineralization were intersected from 61.70 to 63.50 metres, grading 0.61% copper, 4.27 g/t gold, 13.89% zinc, 256.1 g/t silver, and 1.34% lead (10.22% CuEq); from 67.28 to 73.06 metres, grading 2.41% copper, 1.80 g/t gold, 1.00% zinc, 16.9 g/t silver, and 0.06% lead (3.51% CuEq); and from 69.79 to 71.60 metres, grading 5.97% copper, 3.03 g/t gold, 2.14% zinc, 19.3 g/t silver, and 0.03% lead (8.67% CuEq).
Drill Hole | From | To | Thickness | Cu (%) | Au (g/t) | Zn (%) | Ag (g/t) | Pb (%) | CuEq (1) | Approx. True Thickness (m) |
---|---|---|---|---|---|---|---|---|---|---|
CURI-359 | 61.70 | 75.60 | 13.90 | 1.13 | 1.50 | 2.75 | 43.1 | 0.20 | 3.35 | 11.82 |
Including | 61.70 | 63.50 | 1.80 | 0.61 | 4.27 | 13.89 | 256.1 | 1.34 | 10.22 | 1.53 |
Including | 67.28 | 73.06 | 5.78 | 2.41 | 1.80 | 1.00 | 16.9 | 0.06 | 3.51 | 4.91 |
Including | 69.79 | 71.60 | 1.81 | 5.97 | 3.03 | 2.14 | 19.3 | 0.03 | 8.67 | 1.54 |
- Metal equivalency based on US$4.10/lb Cu, US$1,723.50/oz Au, US$1.28/lb Zn, US$25.88/oz Ag and US$0.89/lb Pb; noting that no adjustments were made in the metal equivalency calculation for metal recovery. Prices taken from 6-month contracts for precious metals and 3-month contracts for base metals from the London Metal Exchange, dated March 12, 2021.
Drill holes CURI-358 and CURI-360 were designed to test the outer margins of the Indicated category material and to further assess the pit wall geology. These drill holes confirmed modelling previously done along the margins of the deposit and provide excellent geological control for future modelling studies. Drill hole CURI-358 intersected mineralization in the footwall felsic autoclastic volcanic rocks from 96.13 to 109.00 metres, grading 0.03% copper, 0.15 g/t gold, 0.52% zinc, 6.7 g/t silver, and 0.02% lead (0.36% CuEq) over 8.37 metres approximate true thickness. Drill hole CURI-360 intersected mineralized fine-grained sediments from 50.08 to 51.96 metres, grading 0.03% copper, 2.05 g/t gold, 0.41% zinc, 91.5 g/t silver, and 0.19% lead (2.30% CuEq) over 1.50 metres approximate true thickness.
All results from the current infill definition drilling program will be used to update the Mineral Resource estimate for the El Domo deposit in 2021. The updated Mineral Resource estimate will be part of the ongoing feasibility study for the development of the El Domo deposit (see December 2, 2020 news release).
Figure 1 illustrates the drill locations for the five drill hole results outlined in this news release and the holes currently in the assay lab, or in progress. Drill collar location coordinates are summarized for the infill and geomechanical drilling programs in Table 1 at the end of this news release.
For reference, the last NI 43-101 Mineral Resource estimate for El Domo was published as part of the preliminary economic assessment report titled: “Technical Report on the Preliminary Economic Assessment for the Curipamba Project – El Domo Deposit, Central Ecuador”, with an effective date of June 14, 2019 on SEDAR.
Technical Information and Quality Control & Quality Assurance (“QAQC”)
The Curipamba project work program is being managed and reviewed by Vice President Exploration, Jason Dunning, M.Sc., P.Geo., a Qualified Person within the meaning of NI 43-101. Salazar staff collect and process samples that are securely sealed and shipped to Bureau Veritas (“BV”) in Quito for sample preparation that includes crushing and milling to prepare pulps that are then split for shipment to their facility in Lima, Peru for analysis. All assay data have undergone internal validation of QAQC; noting there is an established sampling control program with blind insertion of assay blanks, certified industry standards and sample duplicates for the Curipamba project. A QAQC program is also in place at BV and includes insertion of blanks, standards, and duplicate reanalysis of selected samples. BV’s quality system complies with the requirements for the International Standards ISO 9001:2000 and ISO 17025: 1999. At BV, gold is analyzed by classic fire assay techniques with an AAS finish, while silver and base metals are analyzed by a 44-element aqua regia technique with ICP-AES finish. Overlimit protocols are in place for gold, silver, copper, lead, and zinc.
Qualified Person
The technical information of this news release has been reviewed and verified as accurate by Mr. Jason Dunning, M.Sc., P.Geo., Vice President Exploration for Adventus, a non-Independent Qualified Person, as defined by NI 43-101.
About Adventus
Adventus Mining Corporation is an Ecuador focused copper-gold exploration and development company. Its strategic shareholders include Altius Minerals Corporation, Greenstone Resources LP, Wheaton Precious Metals Corp., and the Nobis Group of Ecuador. Adventus is advancing the El Domo copper-gold project through a feasibility study, while exploring the broader Curipamba district. In addition, Adventus is engaged in a country-wide exploration alliance with its partners in Ecuador, which has incorporated the Pijili and Santiago copper-gold porphyry projects to date. Adventus also controls an exploration project portfolio in Ireland with South32 Limited as funding partner as well as an investment portfolio of equities in several exploration companies. Adventus is based in Toronto, Canada, and is listed on the TSX Venture Exchange under the symbol ADZN and trades on the OTCQX under the symbol ADVZF.
About Salazar
Salazar Resources Limited is focused on creating value and positive change through discovery, exploration, and development in Ecuador. The team has an unrivalled understanding of the geology in-country and has played an integral role in the discovery of many of the major projects in Ecuador, including the two newest operating gold and copper mines. Salazar Resources has a wholly owned pipeline of copper-gold exploration projects across Ecuador with a strategy to make another commercial discovery and farm-out non-core assets. The Company actively engages with Ecuadorian communities and together with the Salazar family it co-founded The Salazar Foundation, an independent non-profit organization dedicated to sustainable progress through economic development. The Company already has carried interests in three projects. At its maiden discovery, Curipamba, Salazar Resources has a 25% stake fully carried through to production. At two copper-gold porphyry projects, Pijili and Santiago, the Company has a 20% stake fully carried through to a construction decision.
Neither the TSX Venture Exchange nor its Regulation Services Provider (as that term is defined in the policies of the TSX Venture Exchange) accepts responsibility for the adequacy or accuracy of this news release.
This press release contains “forward -looking information” within the meaning of applicable Canadian securities laws. Any statements that express or involve discussions with respect to predictions, expectations, beliefs, plans, projections, objectives, assumptions or future events or performance (often, but not always, identified by words or phrases such as “believes”, “anticipates”, “expects”, “is expected”, “scheduled”, “estimates”, “pending”, “intends”, “plans”, “forecasts”, “targets”, or “hopes”, or variations of such words and phrases or statements that certain actions, events or results “may”, “could”, “would”, “will”, “should” “might”, “will be taken”, or “occur” and similar expressions) are not statements of historical fact and may be forward-looking statements.
Forward-looking information herein includes, but is not limited to, statements that address activities, events, or developments that Adventus and Salazar expect or anticipate will or may occur in the future. Although Adventus and Salazar have attempted to identify important factors that could cause actual actions, events, or results to differ materially from those described in forward-looking information, there may be other factors that cause actions, events or results not to be as anticipated, estimated, or intended. There can be no assurance that such information will prove to be accurate, and actual results and future events could differ materially from those anticipated in such information. Accordingly, readers should not place undue reliance on forward-looking information. Adventus and Salazar undertake to update any forward-looking information except in accordance with applicable securities laws.
For further information from Adventus, please contact Christian Kargl-Simard, President and Chief Executive Officer, at +1-416-230-3440 or christian@adventusmining.com. Please also visit the Adventus website at www.adventusmining.com and LinkedIn page at https://www.linkedin.com/company/adventus-mining-corporation.
For further information from Salazar, please contact ir@salazarresources.com.
Table 1: Drill Collar Information for Infill Drill Holes at El Domo
Hole ID | EAST | NORTH | ELEV | AZIMUTH | DIP | DEPTH | COMMENT |
---|---|---|---|---|---|---|---|
CURI-387 | 695051 | 9855474 | 930 | 26 | -49 | N/A | In Progress |
CURI-386 | 695100 | 9855600 | 943 | 230 | -65 | N/A | In Progress |
CURI-385 | 695094 | 9855482 | 940 | 45 | -54 | 128.0 | Successfully completed per design |
CURI-384 | 695054 | 9855642 | 923 | 136 | -54 | 110.6 | Successfully completed per design |
CURI-383(1) | 695373 | 9855400 | 995 | 270 | -65 | N/A | In Progress |
CURI-382 | 695094 | 9855482 | 940 | 64 | -48 | 156.5 | Successfully completed per design |
CURI-381 | 695214 | 9855602 | 949 | 197 | -57 | 154.4 | Successfully completed per design |
CURI-380(1) | 695375 | 9855000 | 1030 | 270 | -70 | 250.1 | Successfully completed per design |
CURI-379 | 695094 | 9855482 | 940 | 167 | -48 | 153.8 | Successfully completed per design |
CURI-378 | 695054 | 9855122 | 893 | 181 | -57 | 113.1 | Successfully completed per design |
CURI-377 | 695054 | 9855122 | 893 | 55 | -51 | 92.3 | Successfully completed per design |
CURI-376(1) | 695361 | 9855100 | 1087 | 270 | -70 | 275.4 | Successfully completed per design |
CURI-375(1) | 695333 | 9855200 | 1057 | 270 | -75 | 250.1 | Successfully completed per design |
CURI-374 | 695006 | 9855134 | 883 | 296 | -45 | 120.6 | Successfully completed per design |
CURI-373 | 695094 | 9855482 | 940 | 103 | -48 | 197.0 | Successfully completed per design |
CURI-372 | 695041 | 9854913 | 888 | 38 | -45 | 106.3 | Successfully completed per design |
CURI-371(1) | 695399 | 9855298 | 1016 | 270 | -65 | 225.7 | Successfully completed per design |
CURI-370 | 695040 | 9854913 | 888 | 231 | -74 | 86.2 | Successfully completed per design |
CURI-369 | 695094 | 9855482 | 940 | 142 | -48 | 168.7 | Successfully completed per design |
CURI-368 | 695041 | 9854913 | 888 | 331 | -58 | 113.6 | Successfully completed per design |
CURI-367 | 695006 | 9855134 | 883 | 196 | -45 | 102.2 | Successfully completed per design |
CURI-366 | 694975 | 9854918 | 872 | 186 | -72 | 74.5 | Successfully completed per design |
CURI-365 | 694934 | 9855242 | 874 | 151 | -72 | 69.5 | Successfully completed per design |
CURI-364-A | 695131 | 9855402 | 946 | 108 | -60 | 121.8 | Successfully completed per design |
CURI-364 | 695134 | 9855402 | 946 | 108 | -60 | 130.4 | Successfully completed per design |
CURI-363 | 694934 | 9855242 | 874 | 180 | -54 | 95.0 | Successfully completed per design |
CURI-362 | 694975 | 9854918 | 872 | 288 | -61 | 88.9 | Successfully completed per design |
CURI-361 | 695134 | 9855402 | 946 | 75 | -54 | 172.8 | Successfully completed per design |
CURI-360 | 694934 | 9855242 | 874 | 25 | -48 | 83.0 | Successfully completed per design |
CURI-359 | 695006 | 9855134 | 883 | 349 | -69 | 86.5 | Successfully completed per design |
CURI-358 | 694934 | 9855082 | 867 | 255 | -54 | 113.0 | Successfully completed per design |
CURI-357 | 695057 | 9855149 | 894 | 229 | -74 | 105.0 | Successfully completed per design |
CURI-356 | 695006 | 9855134 | 883 | 241 | -77 | 110.6 | Successfully completed per design |
CURI-355 | 695057 | 9855149 | 894 | 36 | -45 | 86.3 | Successfully completed per design |
CURI-354 | 695057 | 9855149 | 894 | 55 | -54 | 81.0 | Successfully completed per design |
CURI-353 | 695094 | 9855122 | 908 | 192 | -45 | 97.4 | Successfully completed per design |
CURI-352 | 695057 | 9855149 | 894 | 306 | -77 | 78.0 | Successfully completed per design |
CURI-351 | 695057 | 9855149 | 894 | 338 | -59 | 77.0 | Successfully completed per design |
CURI-350 | 695094 | 9855122 | 908 | 180 | -57 | 85.7 | Successfully completed per design |
CURI-349 | 695094 | 9855122 | 908 | 263 | -51 | 130.2 | Successfully completed per design |
CURI-348 | 695094 | 9855082 | 910 | 276 | -45 | 135.1 | Successfully completed per design |
CURI-347 | 695094 | 9855082 | 910 | 105 | -54 | 91.0 | Successfully completed per design |
CURI-346 | 695094 | 9855082 | 910 | 52 | -69 | 83.4 | Successfully completed per design |
CURI-345 | 695094 | 9855082 | 910 | 142 | -48 | 95.7 | Successfully completed per design |
CURI-344 | 695094 | 9855082 | 910 | 360 | -60 | 84.1 | Successfully completed per design |
CURI-343 | 695094 | 9855082 | 910 | 192 | -45 | 142.0 | Successfully completed per design |
CURI-342 | 695041 | 9854913 | 888 | 346 | -45 | 137.1 | Successfully completed per design |
CURI-341 | 695134 | 9854922 | 917 | 360 | -60 | 117.4 | Successfully completed per design |
CURI-340 | 695134 | 9854922 | 917 | 360 | -45 | 149.0 | Successfully completed per design |
Notes:
- Geomechanical drill hole for open pit engineering design purposes only; being drilled in addition to the Infill program
- All drill holes are surveyed in UTM Datum (Provisional South American 1956, Zone 17)

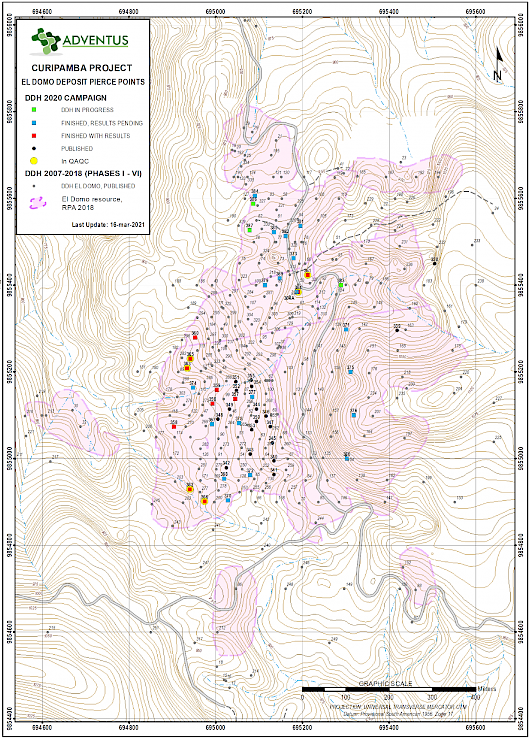

Figure 1: Drill Collar Location Map for Drill Holes at El Domo
